CNSA Extraterrestrial Body Landing Comprehensive Test Field

China Aerospace Science and Technology Corporation.

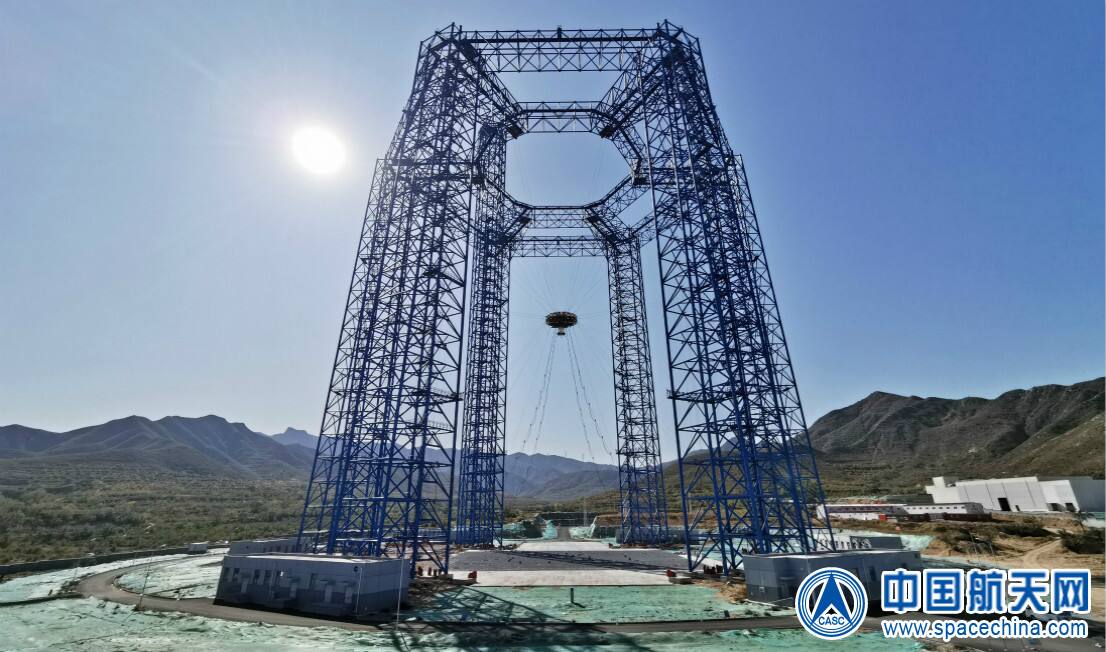

The central Chinese facility for surface-contact testing is the Extraterrestrial Body Landing Comprehensive Test Field at Huailai County, Hebei, described by CNSA as the largest of its kind in Asia [2]. The Chinese name is 地外天体着陆综合试验场; the English form used here is the one carried in the reporting of the 2019 test and has no operator-published equivalent. Its function is gravity offload: a three-dimensional follow-up system hangs the spacecraft from a cable and pulls upward with a constant force so that the net downward force matches the target body, while tracking the vehicle in three dimensions so that the cable stays vertical and adds no horizontal disturbance [1]. The system was built for Chang’e-3, extended for Chang’e-5 take-off testing, and rebuilt on full cable-parallel drive for the Tianwen-1 Mars lander. The Lanyue crewed lunar lander was verified there in August 2025 [4].
Laboratory data
Section titled “Laboratory data”| Parameter | Value |
|---|---|
| Operator | Not established in open sources. See the coverage note [1][2][3] |
| Location | Huailai County, Hebei Province, China [2][3] |
| Commissioned | Chang’e-3 era, upgraded for Chang’e-5, rebuilt for the Mars lander [1] |
| Type | Outdoor gravity-offload landing and take-off test field |
| Floor area | Not published. Ground drive units sit on a 60 m radius circle |
| Capabilities | Follow-up system, earlier builds, terrain |
| Simulant or terrain | Not published as a material |
| Instrumentation | Suspension-point encoder, gyroscopic inertial table, motor-torque rope tension |
| Ground truth | Cable tension and platform pose, measured independently of the article |
| Fidelity limits | 1 g inside the vehicle; last 100 m of descent only. See below |
| Access | National program facility. No external user route published [2] |
| Cited by | zhurong, chang-e-5-sampler |
Capabilities
Section titled “Capabilities”Three-dimensional follow-up system
Section titled “Three-dimensional follow-up system”| Parameter | Value |
|---|---|
| Working volume | 20 x 20 x 80 m, driven at speed and stably [1] |
| Test article limits | Tension 0 to 20 kN, continuously adjustable. Dynamic capacity 3x static |
| Vacuum | Not applicable. Outdoors at ambient pressure |
| Temperature | Not controlled. Outdoor Hebei conditions [1][2] |
| Illumination | Not published. The published campaigns are daylight tests |
| Simulant or terrain | See terrain field |
| Slope | Not published |
| Gravity offload | Constant tension, accuracy 3 parts per thousand or better; tension error below 20 N [1] |
| Instrumentation | Suspension-point encoder and gyroscopic inertial table for rope inclination |
The facility’s whole purpose is gravity offload. A cable hangs the spacecraft and pulls upward with a constant force so that the net downward force matches the target body, while the system tracks the vehicle in three dimensions so that the cable stays vertical and adds no horizontal disturbance [1]. Suspension was chosen over water, air-bearing and free-fall approaches because it can actively follow the article and adds no extra inertia to it.
Two subsystems do the work: a constant tension system, that is the gravity compensation system, using a servo motor and drum in a closed loop through a load cell so the compensating force can be set arbitrarily; and a horizontal follow-up system that tracks the article in the horizontal plane so the rope stays vertical and produces no appreciable lateral component [1]. A universal gimbal at the rope end preserves the article’s pitch, roll and yaw freedom, mounted so the rope tension line passes through the article center of mass. The Mars gravity acceleration simulated is about one third of Earth’s [2][3].
The Mars lander system replaced the gantry crane form with cable-parallel drive throughout. The main hoist has six ground drive units, each with two motors, two reducers and two rope drums, each drum pulling two ropes through sheaves to two swing wheels at 133 m height on the main structure, forming a parallelogram stay mechanism [2][3]. The upper stay system has six units guided by swing wheels at 84 m, the lower stay system six ground units guided by horizontal swing wheels at about 7 m. In total 18 cable-parallel drive units and 36 wire ropes connect to the platform, driven by 24 AC servo motors [2][3]. On the platform itself sit six AC synchronous servo motors: three in the fast horizontal follow-up device, a two-layer carriage with two motors on the upper layer and one on the lower, and three in the tension fine-adjustment device driving the drum that raises and lowers the suspension rope. The tension fine-adjustment stack carries three motors, two for unloading over a 0 to 20 kN range and one for closed-loop control [2][3].
The design requirement is stated as five items:
| Requirement | What it covers |
|---|---|
| Structural load capacity | Static capacity above article, tooling and propellant weight; impact capacity 3 times that |
| Running volume | Set by the landing and take-off maneuvering of the article |
| Velocity and acceleration | Horizontal and vertical, sized by obstacle avoidance under radar and image guidance |
| Constant tension control | Range, accuracy, control angle, disturbance force amplitude and sinusoidal period |
| Control response | Response time, tracking accuracy and overshoot per axis, bus delay, sensor bandwidth |
Earlier builds
Section titled “Earlier builds”| Parameter | Value |
|---|---|
| Working volume | Chang’e-3: 100 m rail travel, 16 x 16 m horizontal following |
| Test article limits | Chang’e-5 test masses 1.5 t landing, 0.8 t take-off, on a 20 t platform |
| Gravity offload | Same constant-tension principle, on a gantry crane form |
| Instrumentation | Six main hoist wire ropes; six ground drive units on a 60 m radius circle |
Source: [1].
The Chang’e-3 system used a three-level hierarchy in which stroke and mass fall and speed and precision rise at each level. The first level covers 100 m of coarse travel on ordinary rails and wheels [1]. The second, on servo motors with gear and rack, covers 16 m by 16 m with real positioning accuracy. The third is the fast follow-up platform itself, hanging below the vertical main hoist on six wire ropes, carrying a two-axis table on servo motors, large-lead ballscrews and precision rails, and a tension fine-adjustment unit made of two motors rigidly in parallel: a large one that carries most of the article weight as a coarse unloader, and a small one running closed-loop on tension so that the fine control has a usable range [1]. Platform stiffness comes from six ground drive units on a 60 m radius circle pulling six stay cables up to the platform, with tension controlled in real time.
For Chang’e-5 the same architecture was extended for take-off tests. Upper stay ropes leave their sheaves at 80 m height and 70 m horizontal radius, lower stay ropes at 5 m height and 60 m radius, both in six symmetric sets at 60 degree spacing, and the platform connects to 18 ropes in total: six upper stay, six lower stay and six main hoist [1]. The vertical main hoist runs on two servo motors of 845 kW at 1250 rpm; the upper stay drive on six AC servo motors of 540 kW at 1750 rpm; the lower stay drive on six of 359 kW at 1750 rpm. Wire rope is 22 mm diameter with 217 square millimeters of effective section [1]. Average set tensions at platform heights of 80, 50 and 10 m are 2.17, 2.18 and 1.36 t on the upper stays, 1.80, 2.10 and 2.10 t on the lower stays, and 10.00, 9.00 and 6.60 t on the main hoist.
Terrain field
Section titled “Terrain field”| Parameter | Value |
|---|---|
| Working volume | Beneath the suspended platform. Extent not published [1] |
| Gravity offload | Supplied by the platform above, not by the field |
The site has a prepared terrain field beneath the suspended platform, visible in the operator imagery, but no source found gives its composition, depth, grain size, preparation procedure or whether it is a simulant at all. What the facility controls is the vehicle’s apparent weight, not the surface it lands on [1].
Instrumentation
Section titled “Instrumentation”The system runs in two modes. In active motion mode the cable-parallel drive moves the platform to commanded motion parameters, the two-layer carriage executes commanded two-degree-of-freedom horizontal motion, and the tension unit pays rope out or in under position or velocity control. In following mode the tension unit runs in force control, holding rope tension constant while paying rope in and out as the article rises and falls; the horizontal unit runs in position-following control so the rope inclination stays small; and the 18 cable drive units move the platform in three dimensions so that the carriage and rope strokes do not run out of travel [1].
Rope tension planning is treated as an optimization rather than a setting. The 36 rope tensions are planned by minimum-variance optimization, the objective being to minimize the sum of squared deviations of the upper and lower stay tensions from their set mean values, subject to bounds on each rope [1]. Because rope tension is regulated through rope length and measured through motor torque, the difference between actual and modeled rope length is calibrated on a regular rectangular grid across the working volume and interpolated at the eight vertices of the enclosing cell with bilinear basis functions [1].
What it does not reproduce
Section titled “What it does not reproduce”The method’s limits are set out by its designers. Suspension gravity compensation must overcome the friction and inertia of the suspension hardware itself, horizontal following is vulnerable to rope vibration and swing, and the two effects couple and constrain each other, so raising system accuracy and dynamic response is difficult and mishandling can drive the system unstable [1].
What the operators claim for the Mars campaign is narrower than an environment simulation: the 2019 run simulated the process of hovering, obstacle avoidance and slow descent under a Martian gravity field of about one third of Earth’s, and verified the correctness of the design [2][3]. The 2025 Lanyue campaign is described in the same terms, as verification of the landing and take-off system scheme, the control scheme, the touchdown cutoff scheme and the interfaces between guidance, navigation and control and propulsion, rather than as a reproduction of the lunar surface environment [4].
Stiffness is bought, not given. Because the platform hangs on flexible cable, the article’s inertia makes the platform hard to keep steady through speed changes, and stiffness has to be imposed by pretensioning ground stay cables. The pretension cannot simply be raised: larger pretension gives more stiffness but demands more motor power and cost, so the design target is the smallest pretension that meets the stiffness requirement, and the achieved horizontal stiffness still varies with height, falling from above 1.8 x 10^6 N/m to about 1.4 x 10^6 N/m when the platform is above 80 m [1].
The envelope is the last 100 m. The tests cover the final landing phase from about 100 m above the target surface, that is hovering, obstacle avoidance, slow descent and touchdown, and on the take-off side the constant-tension hold before mechanical unlock followed by constant-force following after ignition [1]. Everything above that altitude, and the atmospheric entry and descent phases for Mars, is outside the facility.
Gravity is compensated but not changed. The article remains in Earth gravity with an upward rope force removing part of its weight, so internal masses, propellant slosh and any gravity-dependent behavior inside the vehicle still see 1 g. The authors note as the reason for choosing suspension over water and air-bearing methods only that it follows actively and adds no extra inertia, not that it is exact [1].
Campaigns run there
Section titled “Campaigns run there”Chang’e-3 soft landing verification. The Chang’e-3 spacecraft begins hovering at 100 m above the lunar surface to select a landing site, translates to the chosen point once the navigation sensor has fixed it, descends slowly, and below 4 m shuts down the main engine and free-falls to the surface [1]. The three-dimensional follow-up system reproduced the hovering, obstacle-avoidance and slow-descent segments on the ground, balancing part of the vehicle weight through rope tension so that the net upward force matched lunar surface conditions [1].
Chang’e-5 landing and take-off verification. The Chang’e-5 campaign added ascent testing to the Chang’e-3 test set, which drove the addition of the upper and lower stay cable drives alongside the second-level horizontal following and main hoist [1]. See chang-e-5-sampler.
Tianwen-1 lander hover and obstacle avoidance, 14 November 2019. The lander for China’s first Mars mission was run through hovering, obstacle avoidance and slow descent under a simulated Martian gravity field of about one third of Earth’s, as an integrated check of design correctness [2][3]. It was the first public appearance of the Chinese Mars program, watched by ambassadors and envoys from 19 countries and by representatives of the European Union, the African Union and the Asia-Pacific Space Cooperation Organization [2][3]. See zhurong.
Lanyue crewed lunar lander, 6 August 2025. The comprehensive landing and take-off verification test of the Lanyue lunar lander was completed at Huailai [4]. China’s first extraterrestrial landing and take-off test of a crewed spacecraft, it covered many test conditions over a long test period and verified the lunar landing and take-off system design, the control scheme, the touchdown engine cutoff scheme, and the interface match between the guidance, navigation and control and propulsion subsystems. Lanyue consists of a lunar module and a propulsion module, carries two astronauts between lunar orbit and the surface, and can carry a rover and science payloads [4].
